Deep dive · Ethiopia and the Nile

The Grand Ethiopian Renaissance Dam

On the Blue Nile, about 15 km from the Sudanese border, Ethiopia has built the largest power plant in Africa: 5,150 MW, 2.4 times the size of the continent's next-largest hydropower dam and 51% of all the capacity operating in Ethiopia. Its lake, 74 billion cubic metres at full supply level, filled in five rainy seasons from 2020; the dam was inaugurated on 9 September 2025. Ethiopia's electricity output more than doubled in four years, from 15.8 TWh in 2021 to 33.4 TWh in 2025.

This page follows the dam through the data. It measures the lake from space, month by month since January 2019; counts what the dam added to Ethiopia's grid and what Ethiopia now sells to its neighbours; sets out who paid, from the bonds Ethiopians bought to the Chinese credit that built the power lines; and reads the satellite record downstream, at Sudan's Roseires dam and Egypt's Lake Nasser, beside what each government says the dam does.

Register compiled 29 Oct 2026 from 112 sources · the lake measured from Sentinel-2 to Oct 2026 · levels from NASA G-REALM to 22 Oct 2026 · electricity from Ember to 2025

TanzaniaW. SaharaDem. Rep. CongoSomaliaKenyaChadSouth AfricaLesothoZimbabweBotswanaNamibiaSenegalMaliMauritaniaBeninNigerNigeriaCameroonTogoGhanaCôte d'IvoireGuineaGuinea-BissauLiberiaSierra LeoneBurkina FasoCentral African Rep.CongoGabonEq. GuineaZambiaMalawiMozambiqueeSwatiniAngolaBurundiMadagascarGambiaTunisiaAlgeriaEritreaMoroccoLibyaDjiboutiSomalilandUgandaRwandaS. SudanSudan: downstreamEgypt: downstreamEthiopia: GERDGERDAswan
5,150 MWis GERD's capacity: 51% of all the power plants operating in Ethiopia, more than the other 23 together (4,984 MW). The Blue Nile it dams carries most of the water that reaches Sudan and Egypt.Ethiopiadownstream
1,539 km²
of open water on the lake in Oct 2026, measured from Sentinel-2 by this site; 31 km² in Jan 2019, before the first filling
×2.1
Ethiopia's electricity output, 2025 against 2021: 33.4 TWh, almost all of it hydropower (Ember)
57%
of Ethiopians have electricity (2024): about 57 million people still live without it (World Bank)
USD 1.0 bn
Chinese credit for the dam's 500 kV lines, signed in 2013; Ethiopia says the dam itself took no foreign loans (AidData, record 30244)

The dam and its lake

GERD sits in Benishangul-Gumuz, where the Blue Nile, called the Abay in Ethiopia, leaves the highlands for the plains of Sudan. Its lake fills the river's gorge for 172 km upstream, by its builder's count, and spans 143 km from north to south in OpenStreetMap's outline. Hover the map for each feature.

GERD's lake (OpenStreetMap)500 kV lines built for itmain and saddle damsother power plants (GEM)× where the altimeter crosses the lake
EthiopiaSouth SudanSudanTanaKokaRoseires ReservoirGERDAddis AbabaBahir DarGondarAsosaAd-DamazinNekemteDebre MarkosETHIOPIASUDANSOUTH SUDANLake TanaRoseiresBlue Nile
Installed capacity
5,150 MW 13 Francis units in two powerhouses: 11 of 400 MW and 2 of 375 MW (POWER Magazine). Planned at 5,250 MW in 2011, raised to 6,000 and 6,450 MW, cut to 5,150 MW in 2019 by dropping three units. Webuild Value
Design output
15,760 GWh a year As Ethiopia's GERD office gave it in 2019 (ENA); the contractor and consultants say 15,700 GWh. ENA
Main dam
145 m high, 1,780 m long Roller-compacted concrete, 10.7 million m³ of it (Webuild). The contractor says 170 m and the 2017 design paper 175 m at its deepest; no source explains the gap. ASCE Civil Engineering magazine
Saddle dam
5 km long, 50 m high Concrete-faced rockfill closing a low point in the rim, south-west of the main dam. Tractebel gives 5.2 km and 45 m, the design paper 60 m. ASCE Civil Engineering magazine
Storage
74 billion m³ At full supply level; 65 billion m³ usable above dead storage (ELC Electroconsult, the employer's representative). An Egyptian geologist, Abbas Sharaky, argues the usable maximum is 64 billion m³. ASCE Civil Engineering magazine
Full supply level
640 m above sea level ELC Electroconsult says 643 m 'when full'. ASCE Civil Engineering magazine
Lake area at full supply
1,874 km² 1,875 km² by Webuild; 1,904 km² in a 2024 satellite study (PNAS Nexus). OpenStreetMap's outline, drawn on this page, covers about 1,680 km². ASCE Civil Engineering magazine
Lake length
172 km Along the river, by the contractor's count; an uncited figure of 246 km also circulates. Webuild press release
The lake
Nigat Lake (Lake of Dawn) Named at the inauguration, 9 September 2025 (ENA). ENA
Where
Guba, Benishangul-Gumuz, about 700 km north-west of Addis Ababa About 14 km from the Sudanese border by Webuild's count, 15 km by the designer's; others say 20 to 45 km. Natural Earth's border lies 12 km from the dam in a straight line. Webuild project page
Spillways
14,500 m³ a second, gated Six gates; plus an ungated overflow spillway of 2,800 m³/s and two bottom outlets of 830 m³/s (ASCE). ASCE Civil Engineering magazine
Who built it
Ethiopian Electric Power, owner; Webuild (then Salini Impregilo), civil works Studio Pietrangeli designed it; Tractebel and ELC Electroconsult were the employer's representative; Voith Hydro supplied most of the turbines; China Gezhouba took over electromechanical works in 2019 after the state-run METEC was removed (POWER Magazine). POWER Magazine
Workforce
over 25,000 people Over the project's life (Webuild). Webuild press release
Share of Ethiopia's utility output
51.5% of 35,670 GWh Ethiopian Electric Power's fiscal year 2025/26 (July to July), about 18,400 GWh from GERD (derived): above its design average, as the full lake was drawn down. Ecofin Agency

Who gains, who loses, and who says so

GERD in its region: 15 places where it may help or harm, from Ethiopia's grid to the Nile Delta. Colour gives the direction: 7 benefits, 5 harms, and 3 places where the sides or the data pull both ways. Shape gives how it is known: a dot for what is measured or on record, a diamond for what researchers found, a ring for what a government claims. Hover a place, or read the list.

+ benefit− harm± disputedmeasured or on recordfound by researchersclaimed by a governmentpower links, drawn straight
IsraelPalestineLebanonEthiopiaSouth SudanSomaliaKenyaMalawiTanzaniaSyriaSomalilandDemocratic Republic of the CongoLibyaZambiaCentral African RepublicSudanDjiboutiEritreaIraqIranSaudi ArabiaChadKuwaitBurundiRwandaUgandaJordanEgyptYemenBir TawilSeychellesAlbertTanganyikaNyanzaTanaMweruKivuEdwardKyogaRukwaManyaraNyumba ya Mungu ReservoirKwaniaLake AbbeKokaGummareMasinga DamBunyonyiKhashm el-Girba DamNasserRoseires ReservoirTurkanaDead SeaAbayaDead SeaHammarHammarAssalChew BahirChamoAbbeEyasiNatronGreat BitterEGYPTSUDANETHIOPIASOUTH SUDANKENYATANZANIAUGANDASOMALIAERITREALIBYACHADRed SeaIndian OceanMediterraneanGERD+1−2−3+4+5+6+7±8±9−10+11−12+13±14−15
  1. 1. Ethiopia's grid Benefit measured or on record

    Output rose from 15.8 TWh in 2021 to 33.4 TWh in 2025, almost all of it hydropower; about 57 million Ethiopians still have no electricity. Ember · more on this page

  2. 2. Guba and the lake's shores Harm found by researchers

    About 20,000 people, 5,391 households living below 645 m, were to be moved from 14 places into 17 new villages. Researchers found some settled along the road without water; regional leaders expected 80% of Guba district to go under. Vaughan and Gebremichael · more on this page

  3. 3. Nigat Lake Harm found by researchers

    When full, the lake loses about 1.7 billion m³ a year to evaporation, water no one downstream receives; a lower Lake Nasser loses 1.1 billion m³ less. Wheeler et al. 2020 · more on this page

  4. 4. Djibouti Benefit measured or on record

    Took 0.60 TWh from Ethiopia in 2024, by Ember's count, over a link built before GERD, in 2011; a second line has World Bank money. Ember · more on this page

  5. 5. Kenya Benefit measured or on record

    Net imports, by Ember's count, rose from 0.30 TWh in 2022 to 1.54 TWh in 2025 over the 500 kV line from Ethiopia, under a 25-year contract for up to 400 MW; by one report, Ethiopia supplied 83% of Kenya's imports in 2024/25. Green Building Africa · Capital Ethiopia · more on this page

  6. 6. Tanzania Benefit measured or on record

    Buys 100 MW from Ethiopia through Kenya's grid, under a three-way deal signed in January 2025; supply began on trial in 2024/25. Addis Fortune · more on this page

  7. 7. Roseires and Sudan's Blue Nile dams Benefit claimed by a government

    Sudan counts flood control and an even flow through the year among GERD's benefits, if it is told how the dam is run. These dams water 70% of its irrigation schemes and make almost 40% of its power. UN Security Council · more on this page

  8. 8. Head of the Roseires reservoir Disputed measured or on record

    The flood's August rise at the reservoir's head is gone: 493.0 m on average in 2012–2019, 490.2 m in 2023–2026. GERD holding back the flood, or Sudan keeping Roseires low as a precaution: the altimeter cannot tell which. NASA G-REALM · more on this page

  9. 9. The Blue Nile in Sudan, September 2025 Disputed claimed by a government

    Egypt blames GERD's sudden releases for floods in Sudan; Sudan's ministry pointed to heavy rain and the releases together; Ethiopia says GERD lowered the flood and the White Nile caused it. Ahram Online · more on this page

  10. 10. Blue Nile floodplain, Sennar to Khartoum Harm claimed by a government

    Sudan says GERD could halve the floodplain its farmers plant as the flood recedes. UN Security Council · more on this page

  11. 11. Gezira scheme Benefit found by researchers

    A model of the Nile finds that once GERD evens out the Blue Nile, Sudan loses less to floods and silt and gains water for summer irrigation in the Gezira scheme. Wheeler et al. 2020 · more on this page

  12. 12. Khartoum Harm claimed by a government

    Sudan says the 2020 filling, made without notice, shut Khartoum's water stations for over three days; in July 2026 a sudden cut in releases left a drinking-water intake south of Omdurman above the waterline. UN Security Council · Ahram Online · more on this page

  13. 13. Merowe dam Benefit found by researchers

    A model of the Nile finds more hydropower for Sudan once GERD evens out the Blue Nile; Sudan's hydro output rose from 10.2 TWh in 2019 to 11.5 TWh in 2024. Wheeler et al. 2020 · more on this page

  14. 14. Lake Nasser and the Aswan High Dam Disputed measured or on record

    In October 2026 the lake stood at 177.5 m, its lowest October since 2017; yet Egypt's hydropower did not fall while GERD filled (14.7 TWh a year in 2020–25). A model expects the lake to run lower with GERD than without. NASA G-REALM · Wheeler et al. 2020 · more on this page

  15. 15. Egypt's Nile Valley and Delta Harm claimed by a government

    Egypt, which takes 97% of its water from the Nile, says shortages could add up to 120 billion m³ without a binding agreement on filling and operation. A peer-reviewed model finds the risk low in average years; had a 1980s-style drought struck during the filling, it would have added 46 billion m³ to Egypt's shortfall over 20 years. UN Security Council · Wheeler et al. 2020 · more on this page

A claim is not a finding. Egypt, Ethiopia and Sudan each argue their case, at the Security Council and in their ministries' statements; the map says who says what, and the sections below hold the measurements. The power lines are drawn straight between their ends, not along their routes.

Filled in five rainy seasons

The lake as satellites saw it. Above: the water level from radar altimetry, which loses the lake in July 2022 as it rises out of the instrument's window, with the levels reported after each filling, by Ethiopia or by engineers writing about the dam. Below: the area of open water, which this site measured from a clear Sentinel-2 image each month. Shading marks the July–September rains, when the Blue Nile carries most of its year's water and the lake was filled. Hover a point.

measured from spacelevel reported after each fillingpartly clouded imagerainy seasonno clear image (the rains)
First fillingSecond fillingThird fillingFourth fillingFifth filling55057560062565005001,0001,5002,000Water level, metres above sea levelOpen water inside the reservoir's outline, km²20192020202120222023202420252026full supply level, 640 marea at full supply level, 1,874 km²the altimeter loses the lake after 26 Jul 20222123807471,1941,5631,6621,539

The altimeter crosses the lake about 75 km above the dam. In the 2020 and 2021 rains, with the lake still low, the water it measured there was partly the river flowing in, which runs higher than the lake at the dam; its readings and the levels reported at the dam need not match in those months.

Table view: the area, month by month
The reservoir's open water, month by month, measured from Sentinel-2 by this site. Water by the MNDWI index; the scene classification's own water class beside it as a check.
MonthImageWater, km²Scene class, km²Cloud
Jan 201915 Jan 201931330.0%
Feb 201919 Feb 201919290.0%
Mar 201931 Mar 201924290.0%
Apr 20195 Apr 201926290.0%
May 201915 May 201927291.7%
Jun 2019no clear image–––
Jul 2019no clear image–––
Aug 2019no clear image–––
Sep 2019no clear image–––
Oct 201912 Oct 201960401.4%
Nov 201916 Nov 201947420.0%
Dec 201926 Dec 201940400.0%
Jan 20205 Jan 202034350.0%
Feb 20209 Feb 202026330.0%
Mar 202030 Mar 20209310.0%
Apr 202029 Apr 202025300.8%
May 202029 May 202037342.9%
Jun 2020no clear image–––
Jul 2020no clear image–––
Aug 2020no clear image–––
Sep 2020no clear image–––
Oct 202016 Oct 20202411971.5%
Nov 202030 Nov 20202121980.0%
Dec 202030 Dec 20202041830.0%
Jan 20219 Jan 20212031910.0%
Feb 20218 Feb 20211981570.0%
Mar 202110 Mar 20211941670.0%
Apr 202114 Apr 2021189980.0%
May 202129 May 2021196990.3%
Jun 20218 Jun 2021176630.8%
Jul 2021no clear image–––
Aug 2021no clear image–––
Sep 2021no clear image–––
Oct 202121 Oct 20213803012.3%
Nov 202125 Nov 20213803500.0%
Dec 202110 Dec 20213753520.0%
Jan 202229 Jan 20223451680.0%
Feb 202228 Feb 20223421920.6%
Mar 202220 Mar 2022329740.0%
Apr 202229 Apr 2022298732.2%
May 202219 May 2022244362.2%
Jun 2022no clear image–––
Jul 2022no clear image–––
Aug 2022no clear image–––
Sep 2022no clear image–––
Oct 2022no clear image–––
Nov 202225 Nov 20227477180.0%
Dec 202215 Dec 20227296970.0%
Jan 20234 Jan 20236997180.0%
Feb 202323 Feb 20236175310.0%
Mar 20235 Mar 20235704262.0%
Apr 20239 Apr 20236041930.0%
May 2023no clear image–––
Jun 2023no clear image–––
Jul 2023no clear image–––
Aug 2023no clear image–––
Sep 2023no clear image–––
Oct 2023no clear image–––
Nov 202325 Nov 20231,1941,1270.0%
Dec 202310 Dec 20231,1481,1450.0%
Jan 202424 Jan 20241,0321,0010.0%
Feb 202423 Feb 20248347232.9%
Mar 20249 Mar 20241,0276260.0%
Apr 202413 Apr 20249623400.1%
May 20248 May 2024875412.5%
Jun 2024no clear image–––
Jul 2024no clear image–––
Aug 2024no clear image–––
Sep 202420 Sep 20241,5353701.8%
Oct 2024no clear image–––
Nov 202429 Nov 20241,5631,5130.0%
Dec 202424 Dec 20241,5621,5180.0%
Jan 202523 Jan 20251,5471,4750.0%
Feb 20257 Feb 20251,5081,4320.0%
Mar 202516 Mar 20251,4978540.0%
Apr 202518 Apr 20251,4263750.1%
May 20258 May 20251,3993021.1%
Jun 20257 Jun 20251,352660.1%
Jul 2025no clear image–––
Aug 2025no clear image–––
Sep 2025no clear image–––
Oct 202525 Oct 20251,6771,4292.7%
Nov 202521 Nov 20251,6621,5570.0%
Dec 202524 Dec 20251,6201,6000.0%
Jan 20263 Jan 20261,6151,5620.0%
Feb 202617 Feb 20261,5091,2980.0%
Mar 20269 Mar 20261,4528330.0%
Apr 202630 Apr 20261,3402902.3%
May 202623 May 20261,2793090.3%
Jun 2026no clear image–––
Jul 2026no clear image–––
Aug 2026no clear image–––
Sep 202627 Sep 20261,4781702.6%
Oct 202620 Oct 20261,5397720.6%
Table view: the fillings as announced
Each filling as it was announced: the water added and held, in billion cubic metres, and the level reached, in metres above sea level.
FillingAnnouncedAdded, bcmHeld, bcmLevel, mWho said it, and source
First filling21 Jul 20204.94.9560Office of the Prime Minister: first-year target reached AFP via TerraDailyEthiopia's embassy in Brussels later said 4.5 bcm; Sudan said 5. Satellite studies: 3.82 bcm (Landsat, HESS 2023) and 4.3 bcm (PNAS Nexus 2024).
Second filling19 Jul 202113.518.5575Water minister Seleshi Bekele: second filling complete 2Merkato13.5 bcm was the year's target; Reuters reported the minister gave no volume. The 18.5 bcm held is Anadolu's sum of the two targets. ASCE says about 10 bcm in all; satellite studies 8.76 bcm (HESS 2023) and 9.3 bcm (PNAS Nexus 2024).
Third filling12 Aug 2022–22600Abiy Ahmed: 600 m reached, 25 m above the last filling AFP via Phys.org22 bcm is AFP's figure; ASCE says about 25. Satellite studies: 23.1 bcm (HESS 2023), 26.8 bcm (PNAS Nexus 2024).
Fourth filling10 Sep 2023–42620Abiy Ahmed: 'fourth and final' filling complete; no volume given AFP via VOAAbout 42 bcm and 620 m per ASCE; 41 bcm per Sharaky; 625 m per POWER Magazine and Anadolu. A fifth filling followed in 2024.
Fifth filling28 Aug 2024–60640GERD office: the project moves from construction to operation AFP via Arab NewsNo Ethiopian volume. 60 bcm and 638 m on 5 September 2024 per Sharaky; ASCE says the lake stood at 636 m in July 2024 and reached 640 m in December, when the concrete was finished.

Ethiopia gave a volume only for its first two fillings: 4.9 billion m³ in 2020 and 13.5 billion in 2021, the year's target. Two peer-reviewed satellite studies put what the lake held after the first three fillings at 3.8–4.3, 8.8–9.3 and 23.1–26.8 billion m³: the 2021 filling fell well short of its target and 2022's made up the difference. From 2023 Ethiopia announced fillings without volumes. This site's measure, open water rather than volume, shows the same steps; after each rainy season the lake covered 212 km² (2020), 380 km² (2021), 747 km² (2022), 1,194 km² (2023), 1,563 km² (2024), 1,662 km² (2025), 1,539 km² (2026). The 2026 rains, in a year reported as a drought, refilled it only to 1,539 km² by Oct 2026, 123 km² less than a year earlier.

Each year the lake falls through the dry season, from about December to June, as the turbines run, and rises again with the rains: between Nov 2025 and May 2026 it shrank from 1,662 km² to 1,279 km², a 23% fall, before the 2026 rains filled it again. The staircase is the filling; the sawtooth is a hydropower reservoir at work.

The turbines, as they came in
The turbines, as Ethiopia announced them coming into service.
WhenWhatMWMW in serviceSource
20 Feb 2022First unit (Unit 10, 375 MW) starts generating; Abiy inaugurates power generation375375Ethiopian Embassy Belgium
11 Aug 2022Second unit (Unit 9, 375 MW) starts generating375750Fana Media Corporation
24 Aug 2024Third and fourth units (400 MW each; Units 7 and 8) start commercial operation4001,550Ethiopian Monitor
19 Feb 2025Fifth unit (Unit 6, 400 MW) begins generating after pre-commissioning tests; Unit 5 in final commissioning400–Addis Insight
12 Apr 2025Six units operational; project 98.66% complete (cabinet meeting statement)––Libyan Express
16 May 2025Seven of 13 units reported operating during a site visit–2,600EBC
9 Sep 2025Inauguration by Abiy Ahmed; Tractebel says all 13 units in action–5,150Tractebel

Seen from the sky

One clear Sentinel-2 image a year, 10 in all from 2017 to 2026, each taken at the end of the rains, when the lake is near its yearly high: the whole lake on the left, the main dam and the saddle dam beside it on the right. Drag the slider, pick a year or press play.

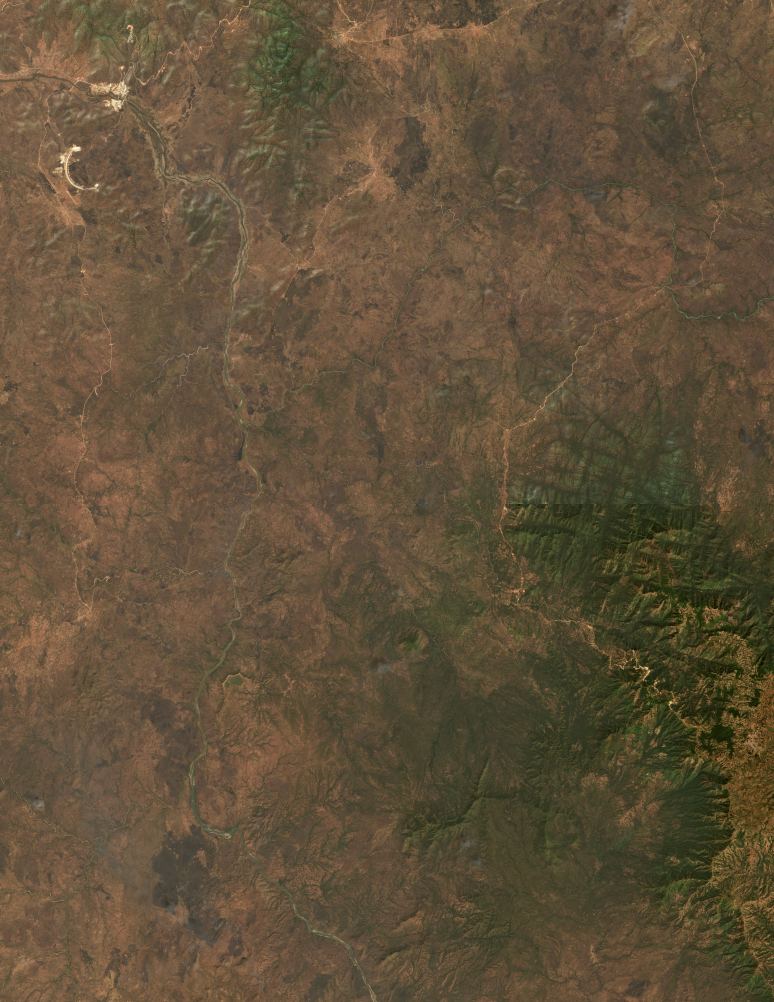

Sentinel-2 image of the GERD lake, 21 Dec 2017
The lake, 100 m a pixel

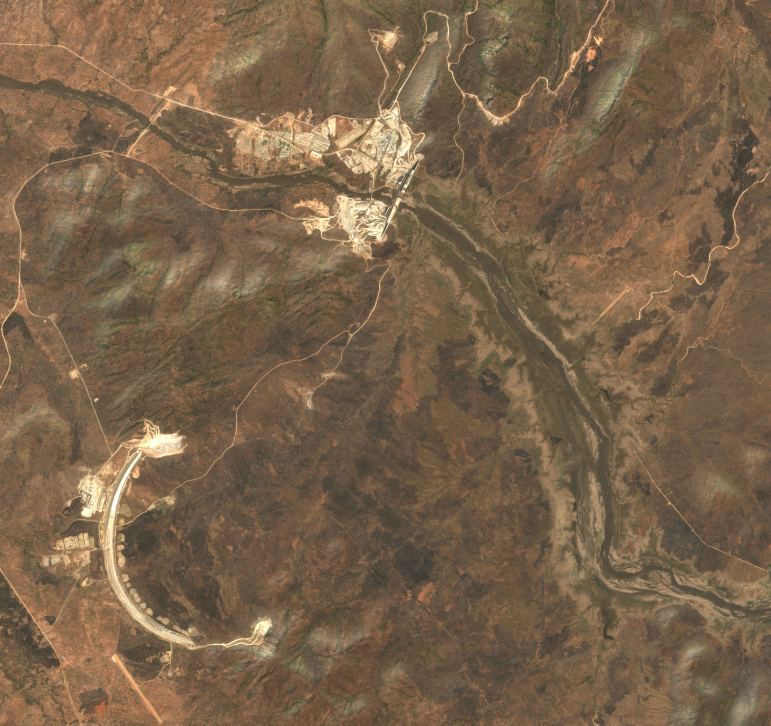

Sentinel-2 image of the GERD main and saddle dams, 21 Dec 2017
The dams, 20 m a pixel

21 Dec 2017 before the first filling · 60% complete (17 Nov 2016) · no turbine running yet

True-colour images (Sentinel-2 bands 4, 3 and 2) as the European Space Agency processes them, cut to the same ground every year and brightened alike. Contains modified Copernicus Sentinel data 2017–2026. The caption's area is this site's measurement for that month, from the chart above.

Ethiopia's grid, doubled

Ethiopia's electricity generation by source, a bar a year, from Ember's yearly data. Hydropower has made almost all of it for twenty-five years; GERD's turbines came in from February 2022. Hover a year.

hydrowind and solarother
010203040200020052010201520202025GERD's first power ↓inaugurated ↓
Table view
Ethiopia's electricity by year, from Ember (which takes it from the US EIA and, for capacity, IRENA). Net exports are Ember's net imports with the sign turned. The latest year may be an estimate and may be revised.
YearHydro, TWhWind and solar, TWhTotal, TWhDemand, TWhNet exports, TWhHydro capacity, GW
202532.21.133.431.02.49.21
202424.40.725.223.41.85.22
202317.10.617.816.01.84.88
202216.80.617.415.71.84.82
202114.90.815.814.11.74.07
202014.90.615.614.01.64.07
201914.40.915.314.21.13.82
201813.70.614.213.21.03.82
201712.60.613.111.71.43.82
201611.60.812.511.21.32.16
20159.60.810.49.70.72.16
20148.90.59.58.70.81.97
20138.30.48.78.00.61.97
20127.30.27.67.00.61.97
20116.20.06.36.00.31.97
20104.90.05.05.00.01.87
20093.50.03.63.60.01.41
20083.30.03.33.30.00.69
20073.40.03.43.40.00.69
20063.20.03.33.30.00.69
20052.80.02.92.90.00.69
20042.50.02.62.60.00.69
20032.30.02.32.30.00.48
20022.00.02.12.10.00.45
20012.00.02.02.00.00.45
20001.60.01.71.70.00.38

Ember takes Ethiopia's generation from the US Energy Information Administration and estimates years not yet published there, so 2025 is provisional.

Hydropower made 14.9 TWh in 2021 and 32.2 TWh in 2025, 96% of all generation. Ethiopia's hydro capacity in IRENA's count, which Ember uses, went from 4.07 GW to 9.21 GW over the same years. Demand at home rose almost as fast as output, from 14.1 to 31.0 TWh.

One dam, half the country's capacity

Ethiopia's largest operating power plants, from Global Energy Monitor's tracker. GERD is larger than all the others put together.

GERD5,150 MW 51%Gilgel Gibe III1,870 MW 18%Beles460 MW 5%Gilgel Gibe II420 MW 4%Tekeze I300 MW 3%Genale Dawa III254 MW 3%Aysha240 MW 2%Adama204 MW 2%Gilgel Gibe I184 MW 2%15 other plants1,052 MW 10%

And still half the country in the dark

The share of people with access to electricity, from the World Bank. Hover a year.

Ethiopiasub-Saharan Africa
0%25%50%75%100%200020052010201520202024Ethiopia 57%Sub-Saharan Africa 55%

In 2024, 56.6% of Ethiopians had electricity, against 23.0% in 2011, the year building began: about 57 million of its 132 million people were still without it. A big dam adds power to the grid; reaching homes takes distribution lines, connections and tariffs people can pay.

Selling the surplus

Ethiopia sells power across three borders. Its net exports, and the net imports of its two main buyers, Kenya and Djibouti, on one scale, from Ember. Hover a bar.

Ethiopia, net exports01232012201520202025Kenya, net imports2012201520202025Djibouti, net imports201220152020

Ethiopia's net exports were 1.66 TWh in 2021 and 2.35 TWh in 2025, 7% of what it generated: most of the new power stays at home. Kenya's net imports rose from 0.30 TWh in 2022 to 1.54 TWh in 2025, as the 500 kV direct-current line from Ethiopia came into use; Djibouti, wired to Ethiopia since 2011, took a steady 0.60 TWh in 2024. Kenya also buys from Uganda, so not all of its imports are Ethiopian.

Power sales: the lines and the deals.
PartnerWhatFigureWhenNote and source
Kenya500 kV direct-current line, Wolayta-Sodo to Suswa1,045 km, 2,000 MW12 Jul 2012World Bank Projects APIUSD 1.26 bn, lent by the World Bank (USD 684 m), the AfDB (USD 338 m) and France's AFD (EUR 91 m). Not part of GERD, but the way its power reaches Kenya.
KenyaPower purchase agreement200 MW, then 400 MW28 Jul 2022Green Building Africa25 years at 6.5 US cents a kWh for the first five; imports began in late 2022.
KenyaNew supply deal, with Ethiopia's distribution utility15.5 US cents a kWh10 Jul 2026Capital EthiopiaOne report; Ethiopia supplied 83% of Kenya's imports in 2024/25.
TanzaniaSales through Kenya's grid100 MW25 Jan 2025Addis FortuneThree-way deal with Kenya's transmission company; trial supply in 2024/25.
DjiboutiSecond interconnection, World Bank creditUSD 66.9 m29 Mar 2022World Bank Projects APIThe first 230 kV link has run since 2011.
SudanContracted supply100 MW25 Jan 2025Addis FortuneBut sales came to USD 0.9 m in 2024/25.

The bitcoin miners

Ethiopia legalised bitcoin mining in 2022, and the miners came for its cheap hydropower, paying in dollars. By the utility's own figures, data mining used 27% of the electricity Ethiopia consumed in 2024/25: enough to account for much of the jump in demand in the chart above. In August 2025 the utility stopped signing new miners; in September 2026, with a drought cutting hydro output, it cut the 31 operating ones to 23% of their contracted power.

Bitcoin mining on Ethiopia's grid, as reported.
WhenWhatFigureNote and source
8 Feb 2024Companies with power deals, 19 of them Chinese21BloombergEthiopia legalised bitcoin mining in 2022 (Bloomberg, via The Block).
9 Aug 2025Tariff miners pay, in dollars3.14 US cents a kWhThe Reporter Ethiopia
7 Aug 2025Share of Ethiopia's electricity use taken by data mining, 2024/2527%StockMarket.etFrom the utility's figures.
7 Aug 2025The utility stops signing new miners–ShegaIts chief executive: no new contracts.
15 Sep 2026Power-purchase agreements with miners (31 operating)39The Edge Malaysia
15 Sep 2026Miners' supply cut, share of contracted power23%The Edge MalaysiaIn stages from 98%, as an El Niño drought cut hydro output.

Who pays in dollars

Ethiopian Electric Power's dollar earnings by fiscal year (July to July), as the utility reported them: what neighbouring countries paid for power, and what bitcoin miners and data centres paid. Hover a bar.

Kenya, Djibouti and Sudanbitcoin miners and data centres
01002003004002022/231012023/24140252024/251182202025/26140336

Who paid

GERD was built without the World Bank or any other development bank, and Ethiopia says without a single foreign loan. It was paid for mostly by loans from Ethiopia's state-owned bank, and in part by money raised from Ethiopians at home and abroad. The lines that carry its power were another matter.

What GERD cost depends on who counts, and in what money. At the launch in 2011 it was put at ETB 80 bn; Salini's contract alone was reported at USD 4.8 bn. By 2024 the estimate in birr had tripled, to ETB 240 bn, yet in dollars the figures quoted at the inauguration were still USD 4–5 bn. Most of the rise is the birr's fall: it went from 16.9 to the dollar in 2011 to 82.6 in 2024, by the World Bank's annual averages, losing 80% of its value. None of the totals says whether the 500 kV lines are in it.

Every cost figure found
What GERD was said to cost, by date. The figures are not comparable: some are in dollars at the rate of their day, some in birr, and not all say what they include.
WhenWhatAmountSource
Apr 2011Estimate at launchETB 80 bnAddis StandardThe birr figure the GERD office used at the start.
Jun 2011Salini's contract, often quoted as the dam's costUSD 4.8 bnENRENR's figure for the main contract; it gives no breakdown.
Mar 2012Salini's contract after its second addendumEUR 3.6 bnSalini ImpregiloCivil works: the main dam, the saddle dam, the two powerhouses and a 400 kV line from Beles that powered the site.
Apr 2014The dam, without the 500 kV linesUSD 4 bnHornAffairsAbout USD 4 bn; the Chinese money for the lines is not included.
Dec 2018Spent so farETB 98 bnThe Reporter EthiopiaAgainst the ETB 80 bn budgeted at the start.
Oct 2020Spent so far, with about ETB 40 bn still to comeETB 121 bnEthiopian Embassy
Apr 2021Revised estimateETB 132 bnThe Reporter EthiopiaExpected to rise with compensation for the main contractor and the birr's fall.
Jul 2024Revised estimateETB 240 bnAddis FortuneWith ETB 80 bn still to find; the GERD office blamed devaluation and inflation.
7 Sep 2025Total at completionETB 233 bnCapital Ethiopia'Over ETB 233 bn', all from Ethiopian sources; the same article's parts (ETB 223 bn of bank loans and ETB 23.8 bn from the public) add up to more.
9 Sep 2025Cost at inaugurationUSD 5 bnENRAbout USD 5 bn by ENR's count; AFP says USD 4 bn.

Bonds, salaries and text messages

The cost as it was stated, in billions of birr, against what the public had put in by each date. Hover a point.

cost, estimatedspent so farraised from the publicbonds alone
010020030020122014201620182020202220242026809812113224023324

Ethiopians bought bonds, gave part of their salaries, sent text messages and played a GERD lottery; the diaspora sent dollars. By 7 Dec 2025 that came to ETB 24 bn. It paid for a shrinking share of the dam: 23% of the spending in 2013, about a tenth by the end. The rest, ETB 223 bn or 91%, came from loans by the Commercial Bank of Ethiopia, the state-owned bank, by the counts of two Ethiopian business papers; neither the bank nor the finance ministry has published a figure.

Table view: what the public put in
What Ethiopians put in, cumulative, as the GERD office and officials reported it.
As ofWhatRaisedWho said it, and source
Aug 2013Collected from the public, of ETB 10.2 bn pledged5.2 bn birrGERD public-participation office Ethiopian Business Review23% of the spending so far.
Jun 2017Pledges received9.4 bn birrEthiopia's embassy in London Water Power MagazineIncluding ETB 64.7 m from a special lottery; diaspora gifts about USD 39 m.
Dec 2018Public contributions12.3 bn birrHead of the public-participation office The Reporter Ethiopia15% of the cost, against the 20% the public was expected to give.
Oct 2020Raised since building began13.9 bn birrENA ENA
Aug 2021Raised since building began15.7 bn birrGERD office ENAETB 2.5 bn in the 2020/21 fiscal year, the most in any year found.
Jan 2025Bond sales alone20.2 bn birrDevelopment Bank of Ethiopia Addis StandardBonds only; the other figures count every channel.
6 Sep 2025Bonds and gifts23.6 bn birrPublic-participation office The Reporter EthiopiaText-message donations alone passed ETB 800 m (Ethio Telecom).
7 Dec 2025Bonds, cash gifts and text messages24 bn birrHead of the GERD office ENA'More than' ETB 24 bn: the latest official total.

The lines: a Chinese credit

China's loans for Ethiopian electricity in AidData's records, largest first, in 2023 dollars. The supplier's credit for GERD's 500 kV lines is the largest of them. Hover a bar for its lender and terms.

GERD's 500 kV lines1,037 m1870MW Gilgel Gibe III Hydropower604 mGibe III Hydro Power Generating Set476 m254MW Genale Dawa III Hydroelectric Power Station381 m153MW Adama Wind Farm II303 mGenale Dawa III-Yirga Alem II-Wolayita Sodo II-Haw…272 mGibe III Hydro Power Transmission and Transformati…257 mAddis Ababa Power Network Rehabilitation and Upgra…237 mPhase II of Aysha Wind Power233 m51MW Adama I Wind Farm128 m23 smaller loans1,292 m

AidData counts 33 Chinese loans for Ethiopian electricity, USD 5.2 bn in 2023 dollars. The largest is the USD 1.00 bn supplier's credit for GERD's lines, signed in April 2013 by China Electric Power Equipment and Technology, a State Grid subsidiary, and refinanced by China Construction Bank and ICBC: 3.08% over 14.7 years, secured on the state utility's receivables. It paid for 85% of a USD 1.2 bn contract; Ethiopia's government paid the rest. CET built 345 km of double-circuit 500 kV line from GERD to a new substation at Dedessa and 275 km on to Holeta, near Addis Ababa, with 400 kV links to Akaki, Sebeta and Sululta, and finished in December 2015, six years before the dam's first turbine turned. In 2019 the loan was restructured to halve payments over five years, about USD 18 m a year of relief for the utility, AidData records. Ethiopia's own aid-management database lists the credit, at ETB 18.6 bn. AidData

The builders

How far along the dam was, as officials said at the time. Hover a point.

0%25%50%75%100%2012201420162018202020222024METEC years: 60% to 68%

Salini Impregilo, now Webuild, signed for the civil works in December 2010, three months before the dam was announced. The electromechanical works went to METEC, a firm run by the army; in August 2018, seven years in and with no turbine yet installed, Abiy Ahmed's new government took them away and split them in 2019 among GE, Voith, PowerChina and China Gezhouba. The design was cut from 16 turbines to 13 at the same time.

Who built GERD: the contracts that have been made public.
CompanyRoleValueAwardedNote and source
Salini Impregilo, now WebuildItalyCivil works: main dam, saddle dam, powerhousesEUR 3.6 bn30 Dec 2010Salini Impregilo Q1 2014 reportSigned with the state utility three months before the dam was announced.
Studio PietrangeliItalyDesign–Studio Pietrangeli websiteWebuild also says it designed the dam.
Tractebel (ENGIE), with ElectroconsultBelgium, ItalyEmployer's representative–2011Tractebel newsSupervising design and building for the utility since 2011.
METEC (Metals and Engineering Corporation)EthiopiaElectromechanical works and hydraulic steelUSD 853 m2011Global Construction ReviewThe army-run firm lost the contract in August 2018, after years of delay.
AlstomFranceTurbines and generators, as METEC's subcontractor250 m7 Jan 2013Alstom press releaseAlstom's page gives no currency; others report euros.
PowerChinaChinaHydraulic steel structures, taken over from METECUSD 126 mJan 2019The Reporter EthiopiaUSD 120 m by another account.
GE Hydro FranceFranceTurbine-generatorsEUR 53.9 mJan 2019Fana BC via Africa ArbitrationReports disagree on how many units: two, five or six.
Voith Hydro ShanghaiGermany, ChinaSix turbine-generator unitsUSD 77.9 m10 Jan 2019Addis FortuneA further USD 113 m for generating-station and spillway works was reported in February 2019.
China Gezhouba GroupChinaPre-commissioning, taken over from METECUSD 40.1 m18 Feb 2019Addis Fortune
China Electric Power Equipment and Technology (State Grid)ChinaThe 500 kV lines and substations, turnkeyUSD 1.2 bn26 Apr 2013AidData record 3024485% of it lent by the contractor itself; see the loans above.

Downstream

The Blue Nile carries most of the water that reaches Sudan and Egypt. The numbers the dispute turns on, with their sources:

The Blue Nile at the border
48.7 billion m³ a year Average yearly flow at El Diem, 1912–1997 (FAO, from Sutcliffe and Parks). FAO Nile poster
The Nile at Aswan
84 billion m³ a year The average the 1959 agreement assumed; a 2020 study of natural flows over 1900–2018 gives 86.5. 1959 Agreement for the Full Utilization of the…
Blue Nile's share at Aswan
55% Of the average yearly flow; the White Nile gives 32% and the Atbara 13% (Wheeler et al. 2020). The 85–86% often quoted is the share that rises in Ethiopia, through the Blue Nile, the Atbara and the Sobat together. Wheeler et al. 2020
…in the high-water season
68% The Blue Nile's share of the river reaching Egypt during the flood (US Library of Congress country study). US Library of Congress
The Blue Nile in July–September
69% of its yearly flow The rains of three months, the months GERD's lake was filled in (UNEP to the Security Council, 2021). UN Security Council
The 1959 agreement
55.5 billion m³ a year for Egypt, 18.5 for Sudan Signed by Egypt and Sudan alone, after setting aside 10 billion m³ for evaporation at the High Aswan Dam. Ethiopia was not a party. FAO Nile poster
The 1929 notes
Egypt's consent for works upstream Exchanged between Egypt and Britain for Sudan and the British territories of East Africa; Ethiopia was neither covered nor a party. Exchange of notes
Lake Nasser's capacity
162 billion m³ Behind the High Aswan Dam, finished in 1970; silt has taken about 7 billion m³ of it. More than twice GERD's. Wheeler et al. 2020
Roseires' capacity
7.4 billion m³ Since the dam was raised by 10 m in 2013; UNEP told the Security Council 5.9 billion m³. A tenth of GERD's. Water Power Magazine
From GERD to Roseires
100 km Downstream, in Sudan. UN Security Council
Evaporation from GERD's lake
1.7 billion m³ a year Net, when full; partly offset by 1.1 billion m³ less evaporation from a lower Lake Nasser (Wheeler et al.). Wheeler et al. 2020
Egypt's water from the Nile
97% AFP and a 2024 study; President Sisi said more than 98% in October 2026. Africanews/AFP
Egypt's water per person
about 500 m³ a year Egypt's figure to the Security Council in 2025, at the threshold of absolute scarcity; it said 560 m³ in 2020. UN Security Council

What the satellites show

The water level at Sudan's Roseires reservoir, 100 km below GERD, and at Egypt's Lake Nasser, from the same NASA altimetry, each on its own scale. Shading marks GERD's filling seasons. Hover a point.

Roseires reservoir, Sudan, metres above sea level487.5490492.5495497.5500201620182020202220242026Lake Nasser, Egypt, metres above sea level170175180185201620182020202220242026
Table view: each year's range
Each reservoir's lowest and highest water level in the year, metres above sea level (EGM2008), from NASA's G-REALM satellite altimetry, and how many readings the year has. The GERD series ends in July 2022, when the rising lake left the altimeter's tracking window.
YearRoseires, mReadingsLake Nasser, mReadingsGERD, mReadings
2026489.6–491.428177.2–180.329–0
2025490.0–495.537177.3–180.636–0
2024488.8–494.334176.2–180.634–0
2023489.0–494.729176.8–180.837–0
2022489.7–497.139178.2–181.145571.9–587.929
2021489.2–495.967178.0–181.171560.9–584.574
2020490.5–495.936176.9–181.335562.3–572.015
2019490.4–495.236176.7–181.032561.5–563.52
2018490.3–494.635174.7–179.535559.1–564.63
2017489.6–495.721172.7–177.634559.6–562.83
2016488.5–495.634172.1–176.359555.9–563.824
2015489.3–494.526175.3–179.036556.4–561.733

At the Roseires crossing, near where the Blue Nile enters the reservoir, the flood used to show each August: the level averaged 493.0 m in the Augusts of 2012–2019. In the Augusts of 2023–2026 it averaged 490.2 m, 2.9 m lower: the August rise is gone. Two things would do that, and the altimeter cannot tell them apart: GERD holding back the flood upstream, and Sudan keeping Roseires low as a precaution because it is not told how GERD will be run, as Egypt's water minister said its operators did in 2026. Roseires holds a tenth of what GERD holds.

Lake Nasser, behind the Aswan High Dam, was near its highest in the years GERD was first filled: its October level averaged 180.9 m in 2019–2022. In October 2026 it stood at 177.5 m, the lowest October since 2017, and falling rather than rising with the flood. The altimeter cannot say why: the rains, GERD's releases and Egypt's own releases from Aswan all move it. In Ethiopia, 2026 was reported as a drought year: the utility cut its bitcoin miners' power to a quarter of their contracts in September.

Egypt, hydropower output051015202010201520202025Sudan, hydropower output201020152020

Egypt's hydropower, almost all of it from the Aswan dams, produced 13.1 TWh in 2019 and 14.7 TWh a year on average in 2020–2025, the filling years; Sudan's, 10.2 TWh in 2019 and 11.5 TWh in 2024. Neither fell while GERD filled.

What each side says

What each side says GERD does downstream, as they said it. These are claims, not measurements; the satellite series above are the measurements.
WhoSaysFigureWhenSource
EthiopiaThe first filling holds back about a tenth of the Blue Nile's yearly flow; Lake Nasser loses twice that to evaporation every year.–29 Jun 2020UN Security Council
Wheeler et al. (model)Filling in average years, Egypt can still release its 55.5 billion m³ a year, but Lake Nasser falls to levels not seen in decades.–16 Oct 2020Wheeler et al. 2020
Wheeler et al. (model)A drought like the 1980s' during the filling would add 46 billion m³ to Egypt's shortfall over 20 years.46 billion m³16 Oct 2020Wheeler et al. 2020
EgyptWithout a binding agreement on filling and operation, shortages in Egypt could add up to 120 billion m³.120 billion m³8 Jul 2021UN Security Council
SudanThe 2020 filling, made without notice, dropped the Blue Nile suddenly and shut water stations in Khartoum for over three days.–8 Jul 2021UN Security Council
SudanGERD could halve the floodplain Sudanese farmers plant as the flood recedes.50%8 Jul 2021UN Security Council
SudanRun with information shared, GERD would protect Sudan from floods and even out the river's flow through the year.–8 Jul 2021UN Security Council
SudanRoseires and the other Blue Nile dams water 70% of Sudan's irrigation schemes and make almost 40% of its electricity; their safety depends on GERD's data.70%8 Jul 2021UN Security Council
EthiopiaGERD is for Sudan what the High Aswan Dam is for Egypt.–8 Jul 2021UN Security Council
Ali, Melsen and Teuling (satellite)The first three fillings held back 5–14% of the Blue Nile's yearly flow, and cut flows to Sudan sharply in the filling months.13.7% at most2023Ali
Abdelmohsen et al. (satellite)Much of the water stored after each filling was lost underground: about 20 billion m³ of seepage in 2019–2022, by this one study's estimate.19.8 billion m³6 Jun 2024Abdelmohsen et al. 2024
EgyptAbove-average floods have so far given Egypt relative protection from major harm.–1 Sep 2024UN Security Council
EgyptHarm already comes from having to manage variable, unpredictable flows from upstream.–9 Sep 2025UN Security Council
SudanThe September 2025 rise came from heavy rain and GERD's releases once the lake was full.750 million m³ a day, peak30 Sep 2025Ahram Online
EgyptSudden releases in September 2025, peaking on the 27th, worsened floods in Sudan.780 million m³ a day3 Oct 2025Ahram Online
EthiopiaGERD lowered the 2025 flood: before it, the Blue Nile peaked above 800 million m³ a day; Sudan's floods came mainly from the White Nile.472 million m³ a day, September average4 Oct 2025Ethiopia Ministry of Water and Energy
EgyptReleases in November 2025 ran 80% above the historical average; Egypt opened the Toshka spillway.180 million m³ a day22 Nov 2025Ahram Online
SudanIn July 2026 the Blue Nile's inflow to Roseires fell by over a third in two days as GERD cut its releases.129 million m³ a day21 Jul 2026Ahram Online

From Project X to inauguration

Fifteen years of building, filling and talks, as the record shows them. The talks never produced the binding agreement on filling and operation that Egypt and Sudan sought.

Where the sources disagree

Figures in this register that differ between sources, and what this page does with them.

How this page was made

The lake's area
Measured by this site from Copernicus Sentinel-2 Level-2A images, read from Element 84's Earth Search catalogue on AWS. For each month the script takes the clearest image covering the whole lake and counts open water inside OpenStreetMap's outline of the reservoir, widened by 1 km: water where the modified normalised difference water index (green against short-wave infrared) is above zero, on a 60 m grid. An image is used only if less than 3% of the outline is under cloud. The scene classification's own water class is kept as a check in gerd_area.json; in some dry-season months it misses most of the lake, likely algae or haze, which is why the index is used. 62 of 94 months have a clear image; in the rains, July to September, most have none. The figure is open water: the lake's flooded margins and forest are not counted, so its peak stays below the design area. Smoke and haze in the dry-season burning months can hide water the cloud mask does not catch, so month-to-month wiggles of about a tenth are within the measure's noise; images with more than 1% cloud are drawn hollow and not quoted. The yearly steps are what the series shows reliably. Only one of the two satellite tracks over the lake covers all of it, so some months, October 2023 among them, have no usable image.
The images
One Sentinel-2 true-colour image a year (ESA's TCI product, bands 4, 3 and 2), the clearest of November and December, or of October for the current year, with under 3% cloud over the lake view. Each is cut to the same ground on a fixed grid, 100 m a pixel for the lake and 20 m for the dams, and brightened by the same gamma, by fetch_gerd_images.py. Earth Search's archive of these images over GERD begins in December 2017. Contains modified Copernicus Sentinel data.
Water levels
NASA Goddard's Global Water Monitor (G-REALM, formerly run by the US Department of Agriculture), public domain: 10-day radar altimetry from TOPEX/Poseidon, the Jason satellites and Sentinel-6A, in metres above sea level (EGM2008). GERD's lake is its target "Millennium", the dam's name before 2011; its track crosses the lake about 75 km above the dam, and the series ends in July 2022, when the rising water left the window the altimeter tracks. The Roseires crossing is near the reservoir's head, by the border, where the river enters it. Lake Nasser's and Lake Tana's series run to 22 Oct 2026.
Electricity
Ember's yearly electricity data (CC BY 4.0), which for Ethiopia, Sudan and Djibouti takes generation and trade from the US Energy Information Administration and capacity from IRENA; Ember estimates years its sources have not yet published, so the latest year may be revised. Access to electricity and population: the World Bank's World Development Indicators (CC BY 4.0). Power plants: Global Energy Monitor's Global Integrated Power Tracker (CC BY 4.0), as on this site's map.
Money
The Chinese loans are AidData's, from its China's Global Loans and Grants dataset (CC BY 4.0), as on this site's map: amounts in constant 2023 dollars, with the nominal amount in each tooltip. Everything else on cost, financing and contracts is in the register, each figure with the page it was read from.
The register
Kept by hand in gerd.json: the dam's facts, the fillings and turbines as announced, cost, financing, contracts, power sales, the Nile's numbers, the timeline and the disagreements, each with its source. Compiled from official statements, the UN Security Council's records, company releases and news reports, read on 29 Oct 2026. Reuters, AP and Bloomberg could not be read directly, so much of the reporting on Egypt's side since 2023 comes from Ahram Online, which the Egyptian state owns; the Egyptian ministry's figures for GERD's releases have not been checked against an independent source.
The map
The reservoir, the main dam and the saddle dam from OpenStreetMap (ODbL 1.0), fetched 29 Oct 2026; the 500 kV lines are AidData's footprint of the Chinese-financed project; rivers, lakes and towns from Natural Earth.
Files
Built by build_gerd.py; --fetch rereads Ember, the World Bank, G-REALM and OpenStreetMap. The area series is remeasured by fetch_gerd_area.py, which needs rasterio.
